Installation Design

Installation Planning: The Foundation of Project Success

Successful construction projects are built long before materials arrive on site. Effective installation planning ensures that every component is coordinated, sequenced, and positioned for efficient execution, reducing delays, minimizing rework, and improving overall project performance.

Installation planning bridges the gap between design and construction by evaluating how building systems, structural elements, and architectural features will be assembled in the field. Through detailed coordination, constructability reviews, and installation sequencing, potential conflicts can be identified and resolved before they impact the schedule or budget.

A well-developed installation plan provides clear direction for project teams, improves communication among stakeholders, and helps maintain productivity throughout the construction process. By understanding installation requirements early, teams can optimize material deliveries, equipment access, labor resources, and site logistics.

The result is a safer, more efficient construction process that delivers higher quality outcomes, greater cost certainty, and a smoother path from design to completion. Installation planning is not simply a project phase—it is a critical strategy for ensuring successful project delivery.

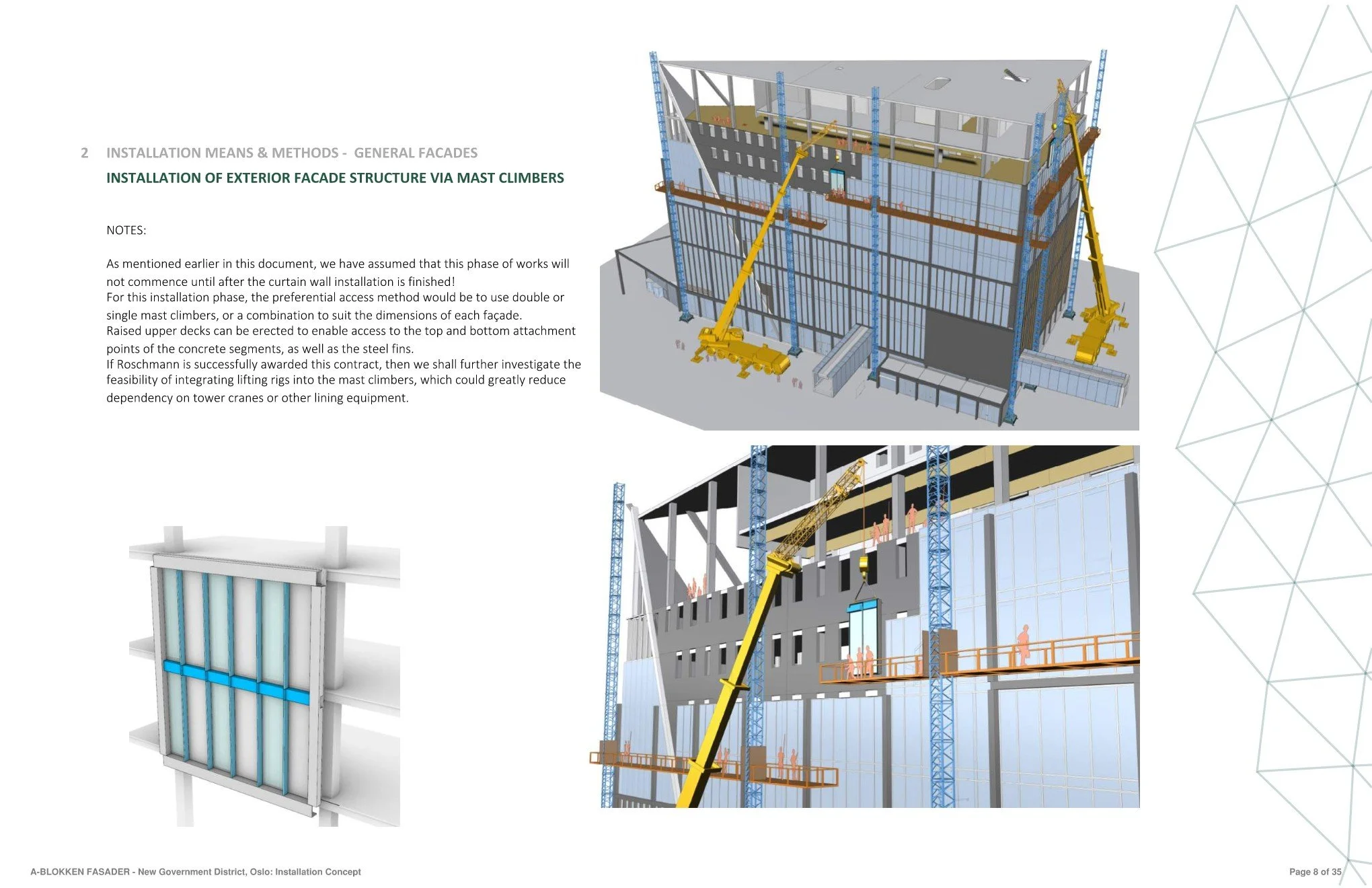

10804-LWG-Means&Methods-Rev-3.1--06-11-21 Page 008.jpg
10804-LWG-Means&Methods-Rev-3.1--06-11-21 Page 009.jpg
10804-LWG-Means&Methods-Rev-3.1--06-11-21 Page 010.jpg

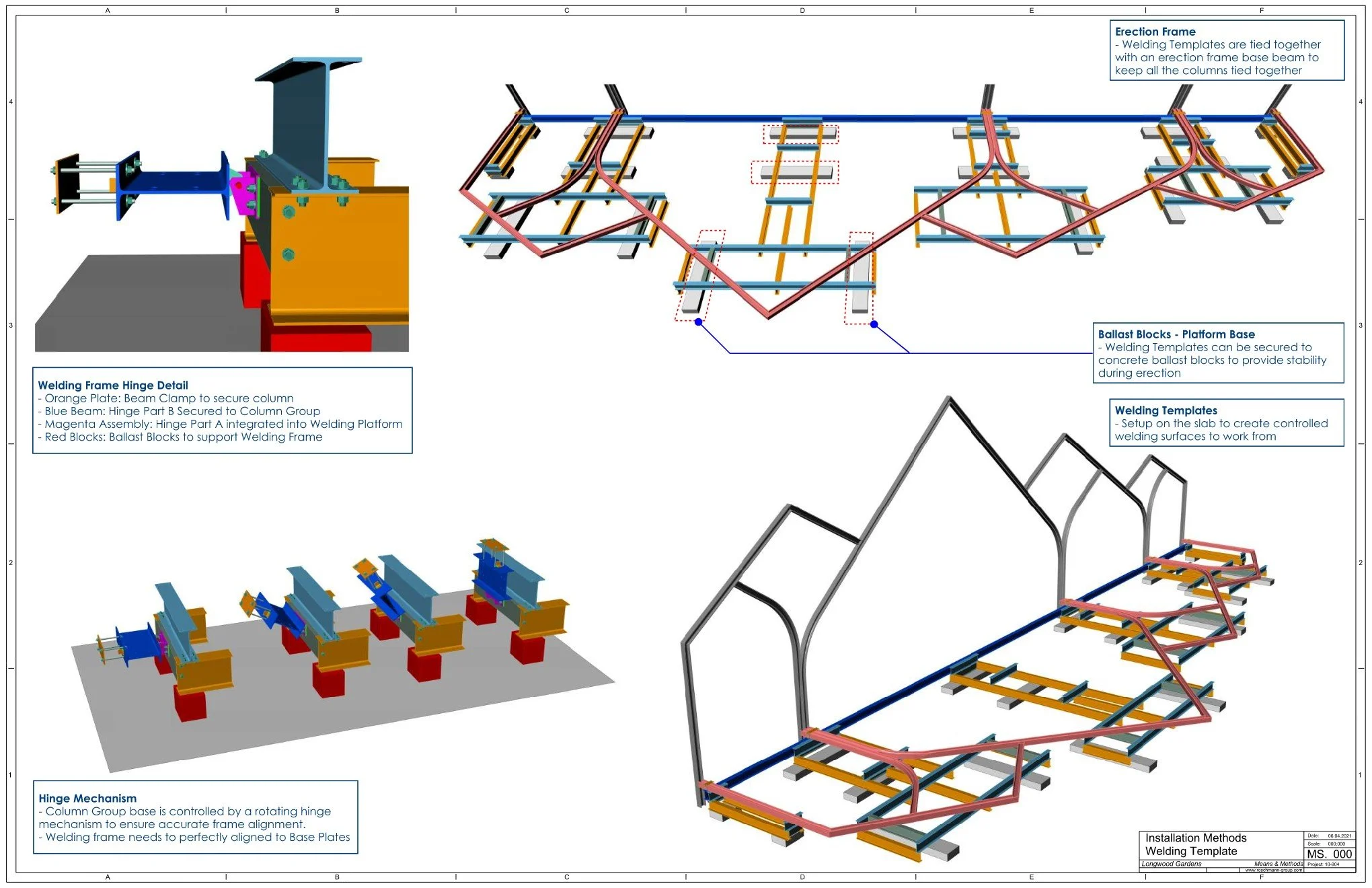

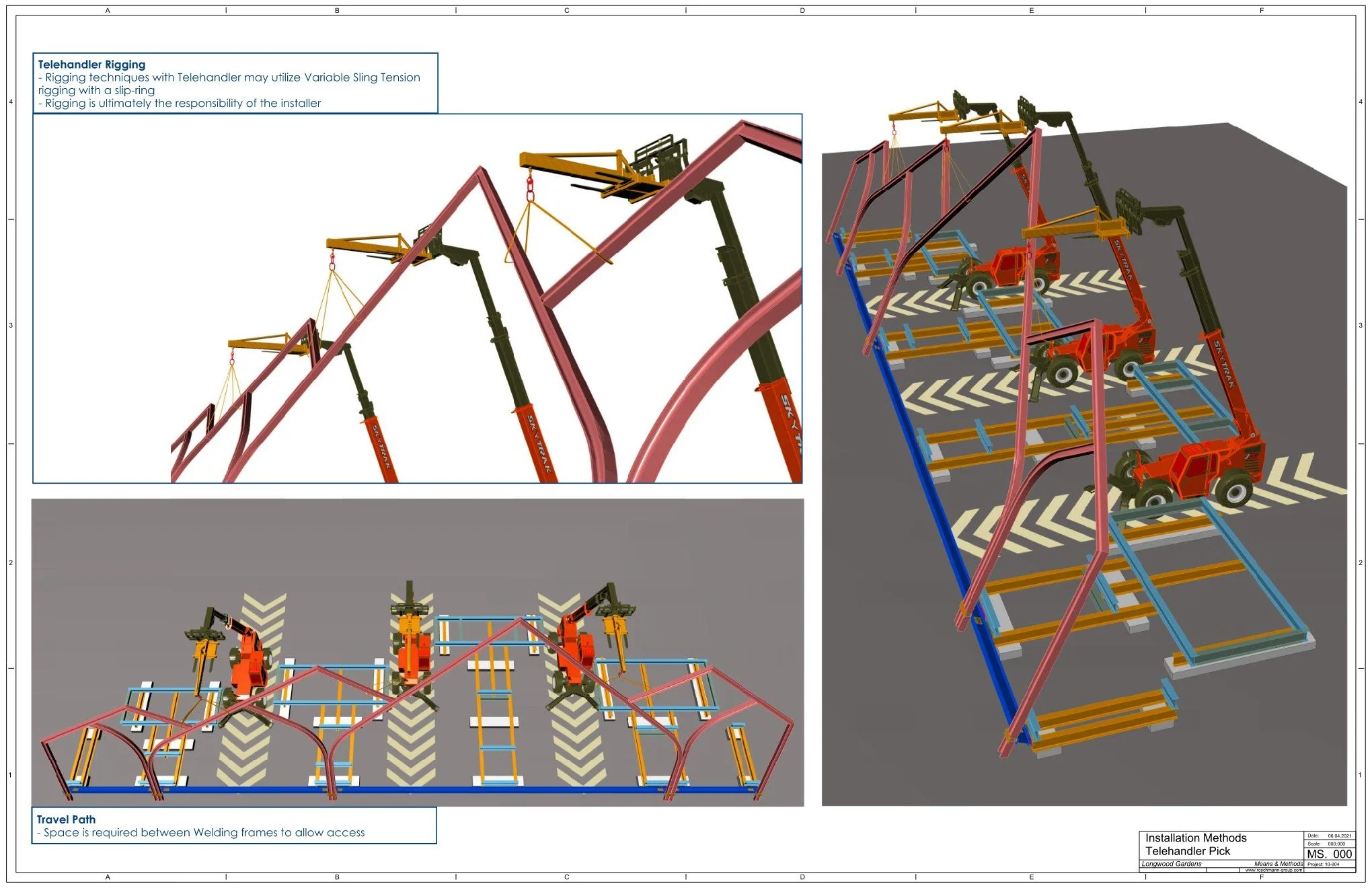

10804-LWG-Means&Methods-Rev-3.1--06-11-21 Page 011.jpg
10804-LWG-Means&Methods-Rev-3.1--06-11-21 Page 012.jpg

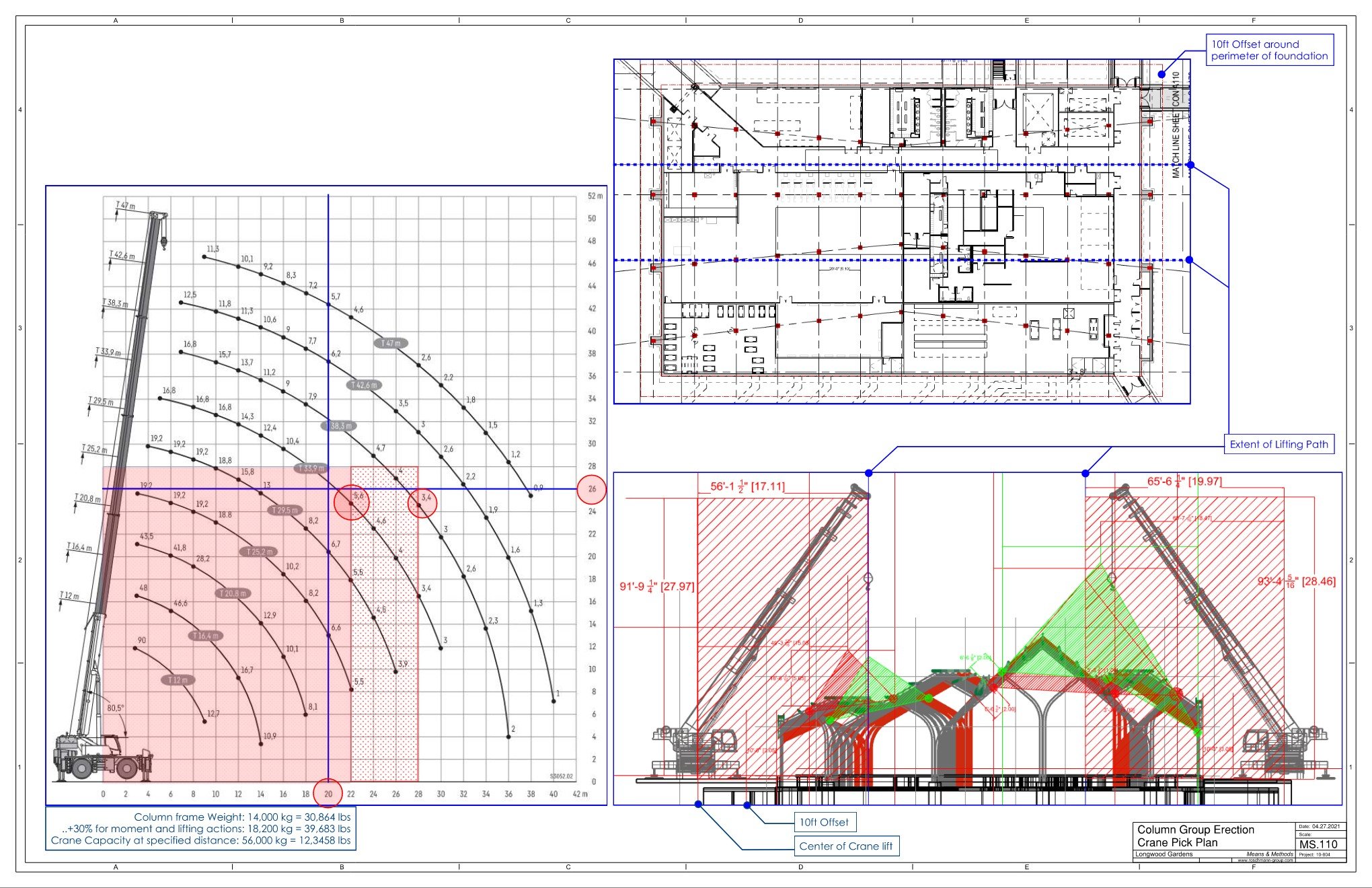

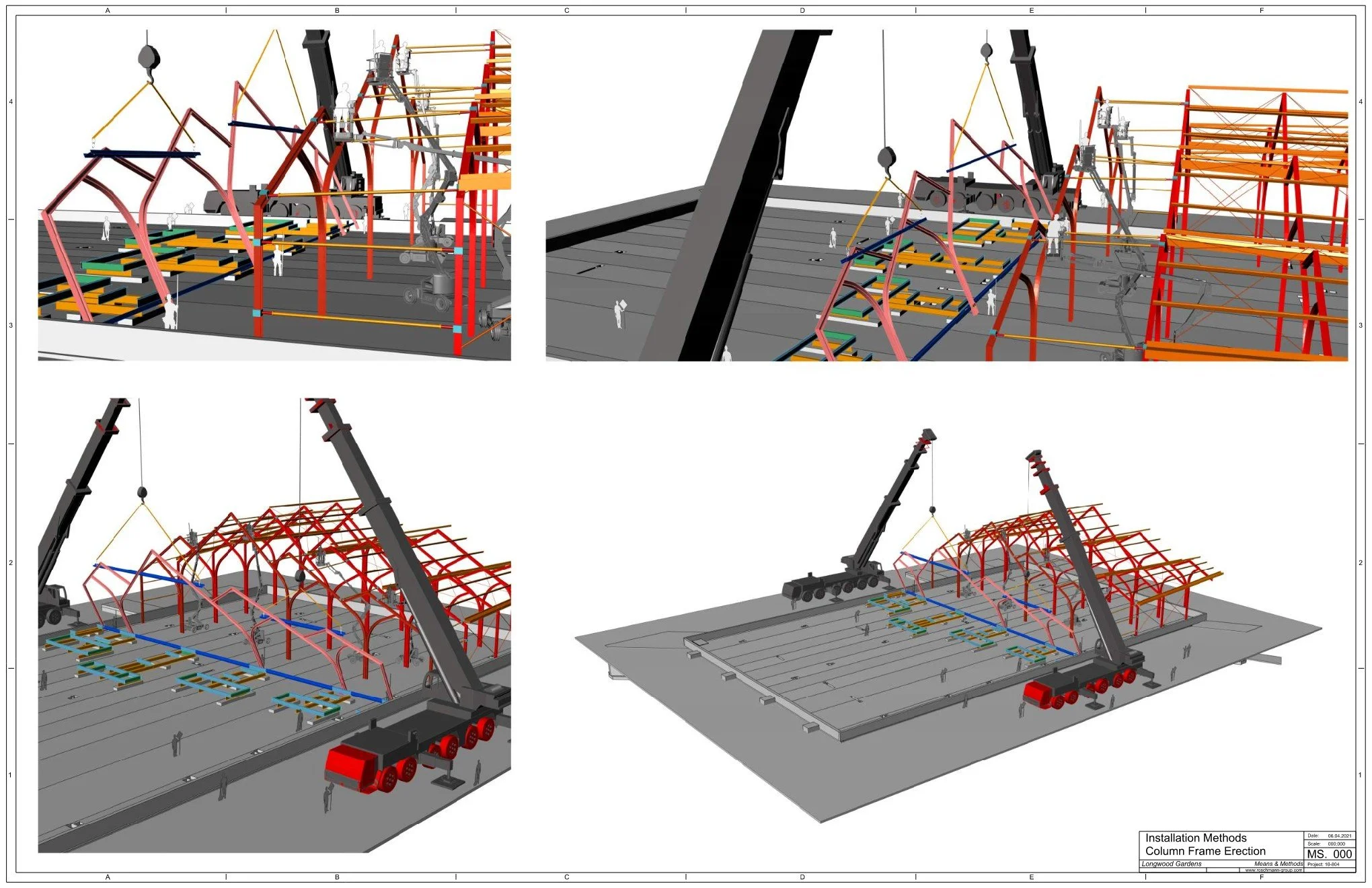

10804-LWG-Means&Methods-Rev-3.1--06-11-21 Page 013.jpg

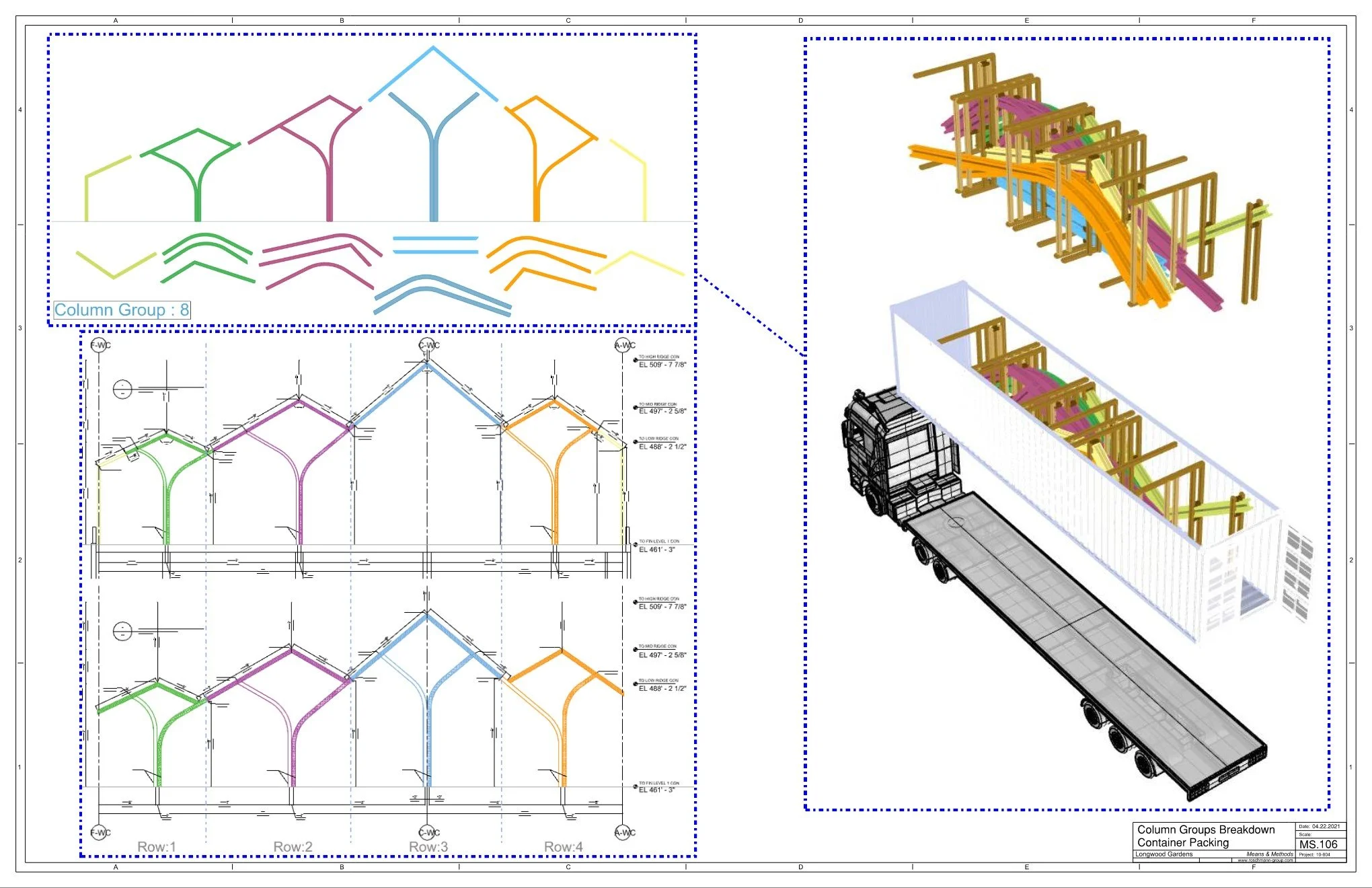

10804-LWG-Means&Methods-Rev-3.1--06-11-21 Page 016.jpg

OSLO_BLOCK-A_Rev-1A Page 005.jpg

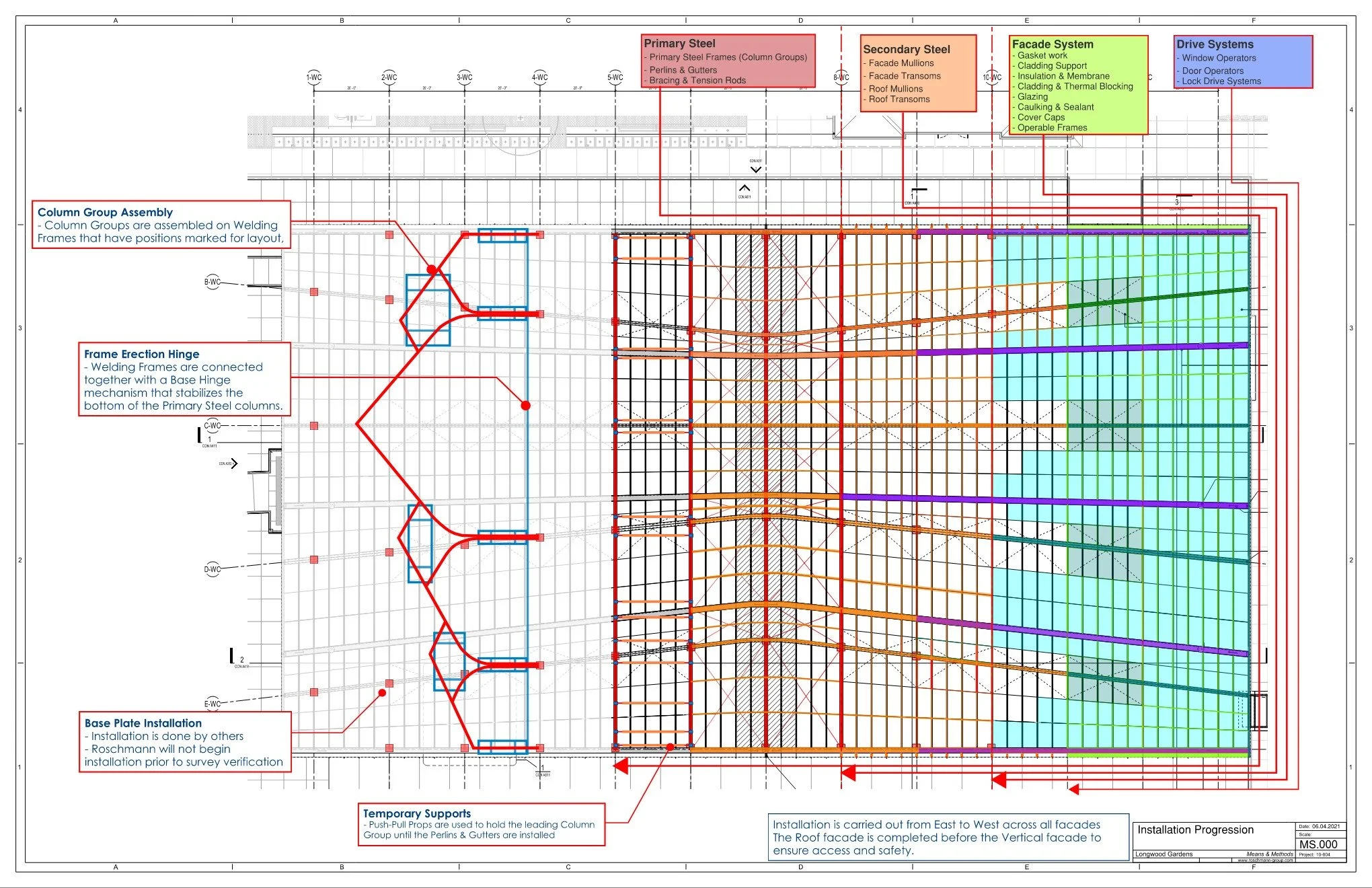

OSLO_BLOCK-A_Rev-1A Page 007.jpg

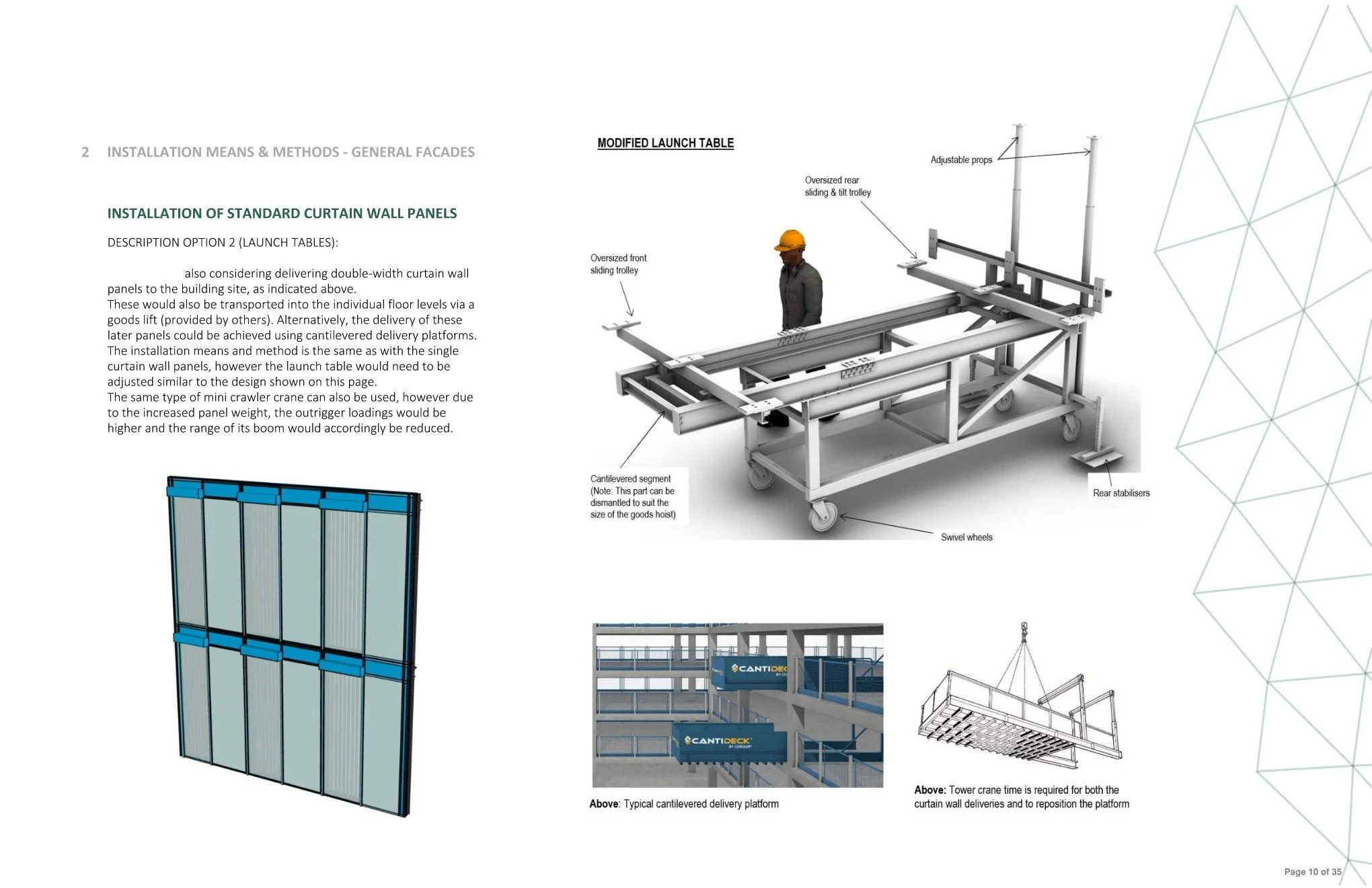

OSLO_BLOCK-A_Rev-1A Page 009.jpg
OSLO_BLOCK-A_Rev-1A Page 018.jpg

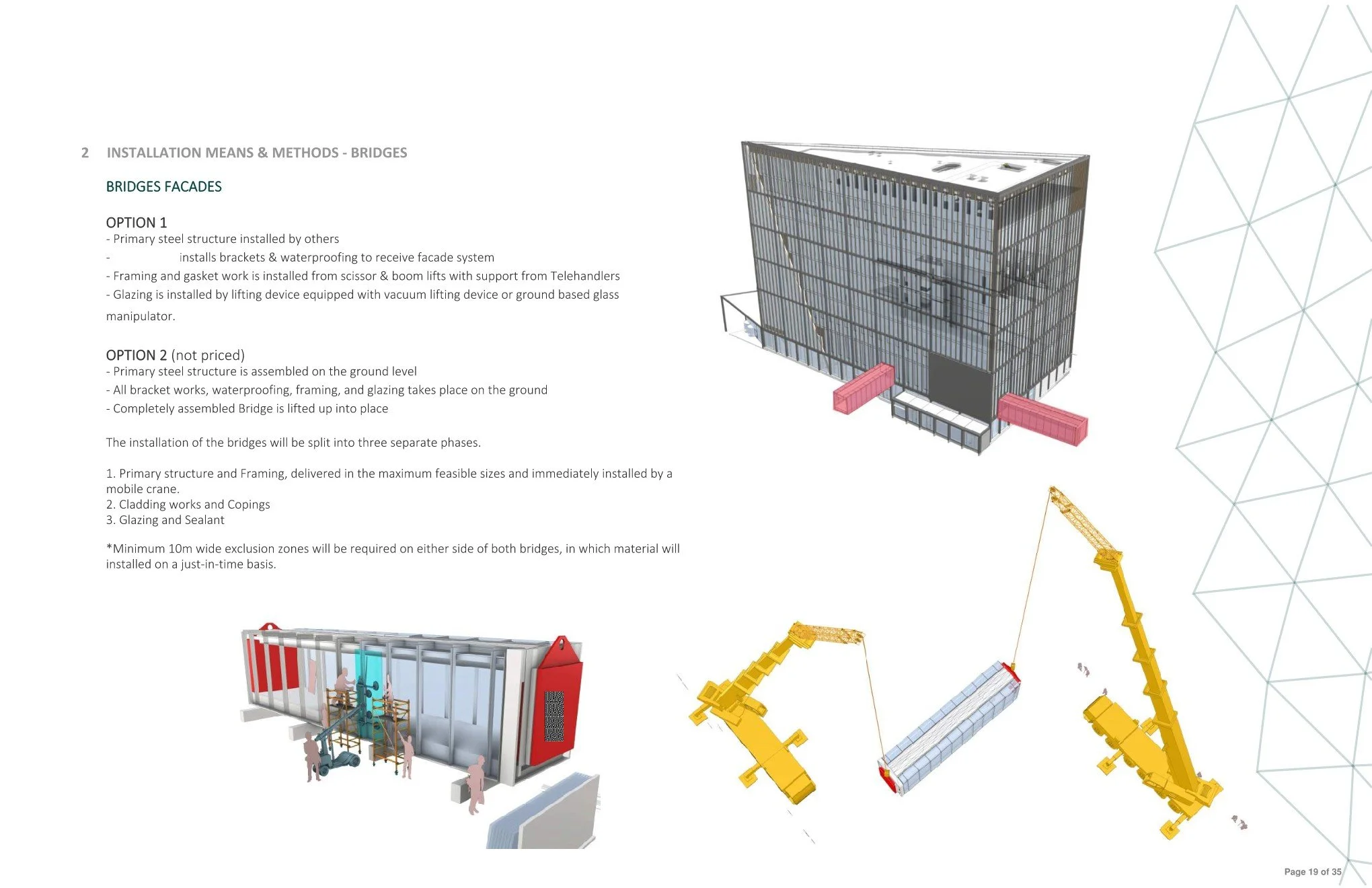

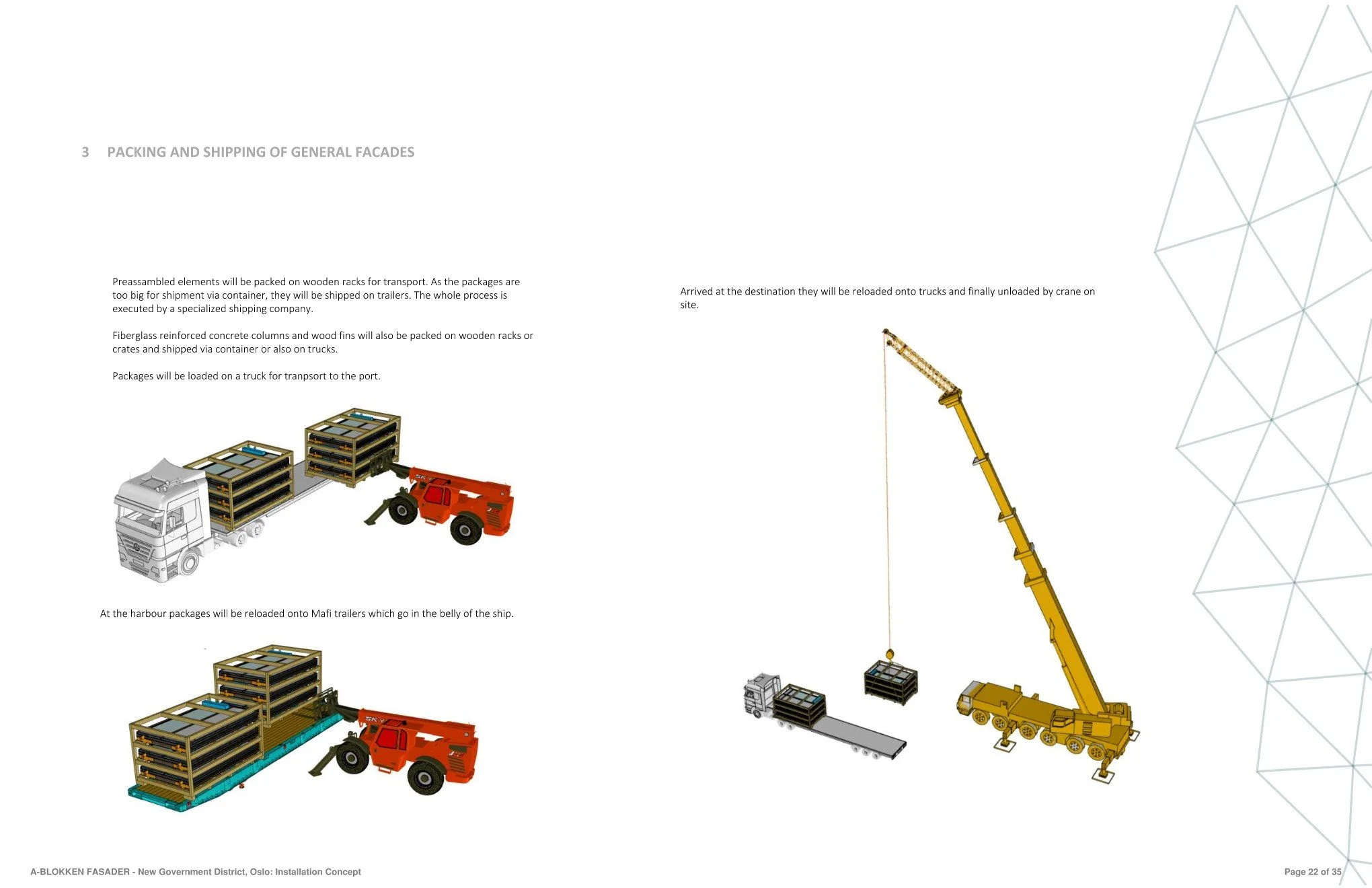

OSLO_BLOCK-A_Rev-1A Page 021.jpg

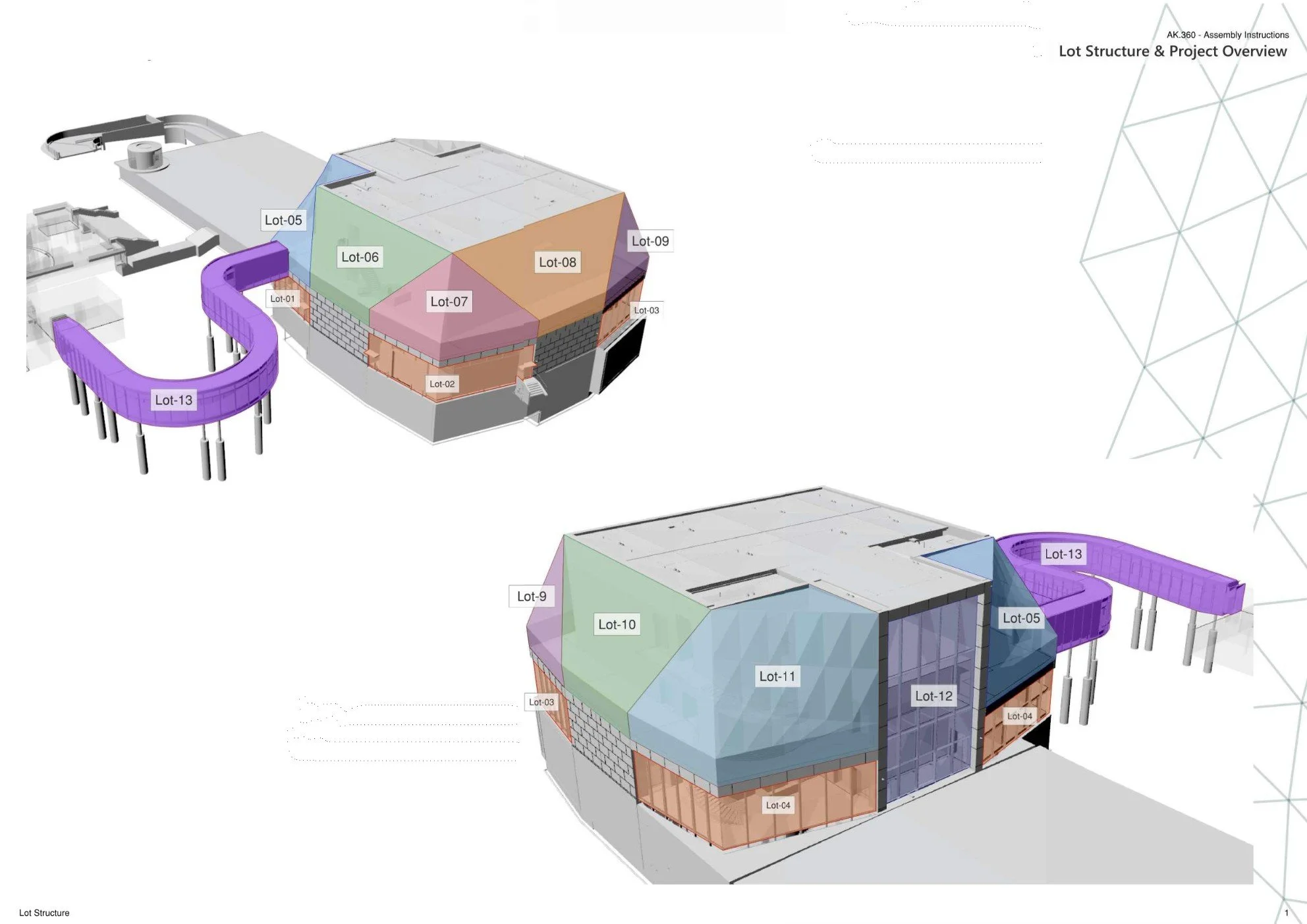

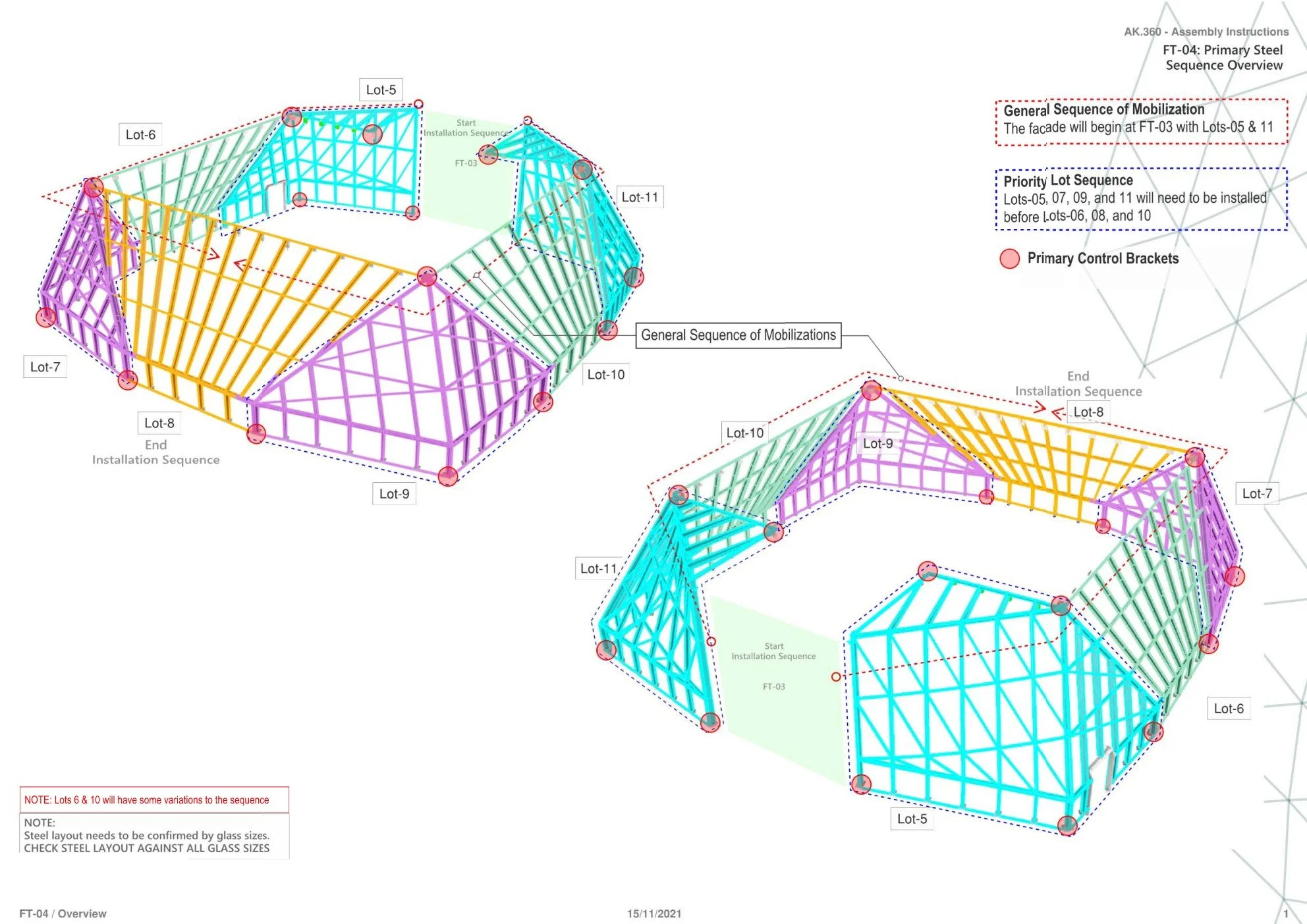

AK-360_FT-04_Primary Steel Assembly Instructions_SET Page 001.jpg
AK-360_FT-04_Primary Steel Assembly Instructions_SET Page 002.jpg

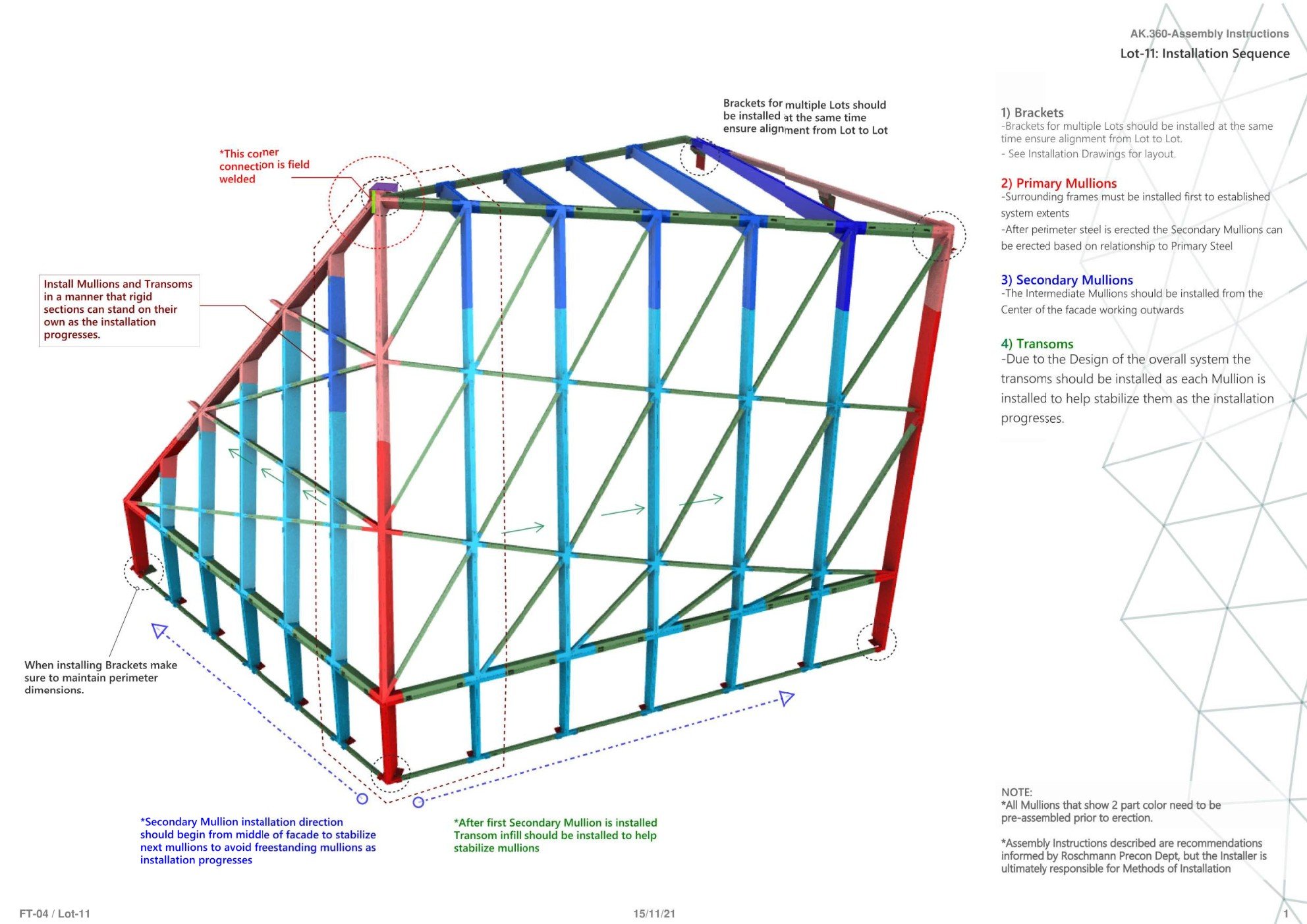

AK-360_FT-04_Primary Steel Assembly Instructions_SET Page 003.jpg

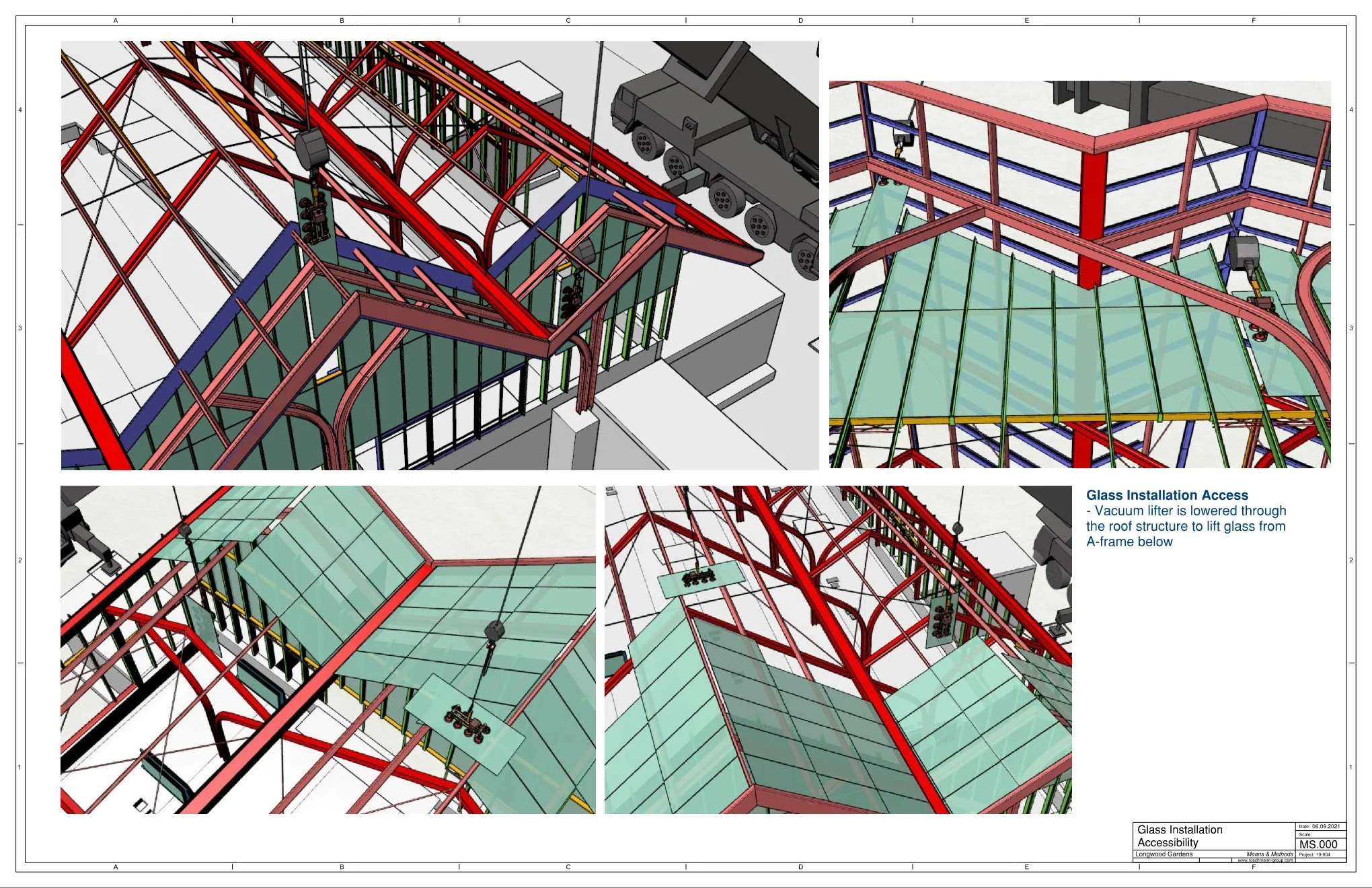

10804-LWG-Means&Methods-Rev-3.1--06-11-21 Page 018.jpg

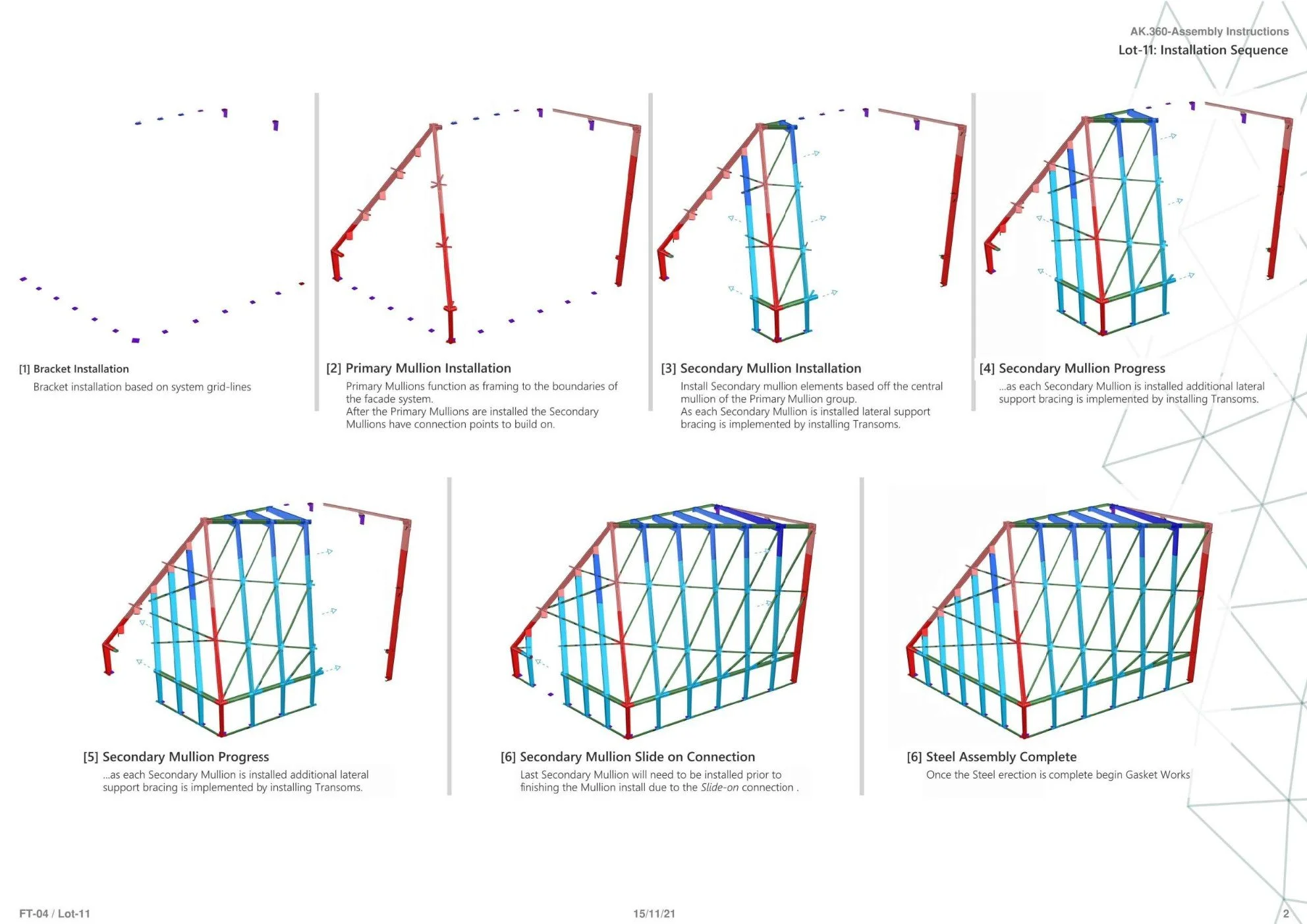

AK-360_FT-04_Primary Steel Assembly Instructions_SET Page 004.jpg

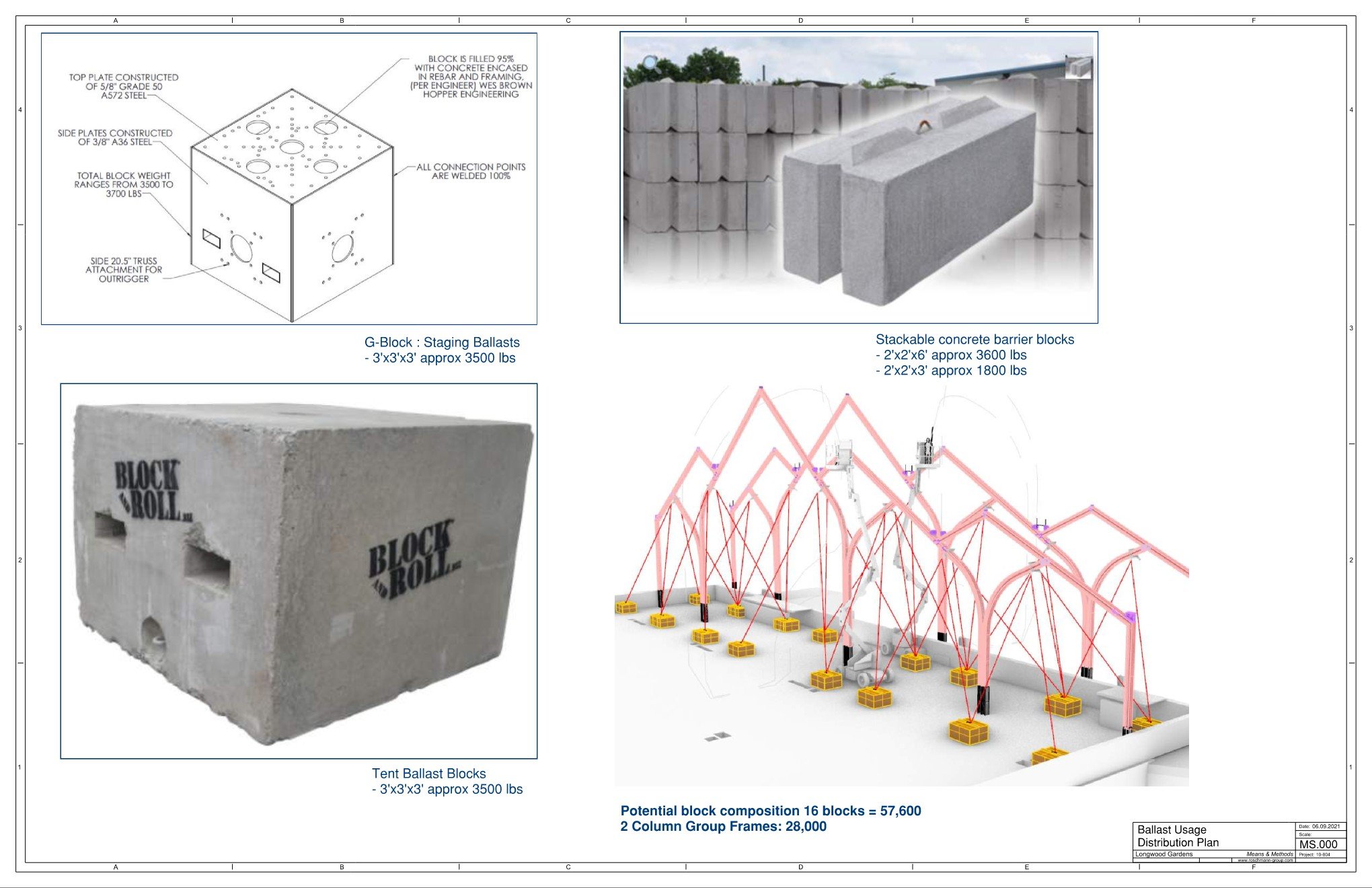

10804-LWG-Means&Methods-Rev-3.1--06-11-21 Page 019.jpg

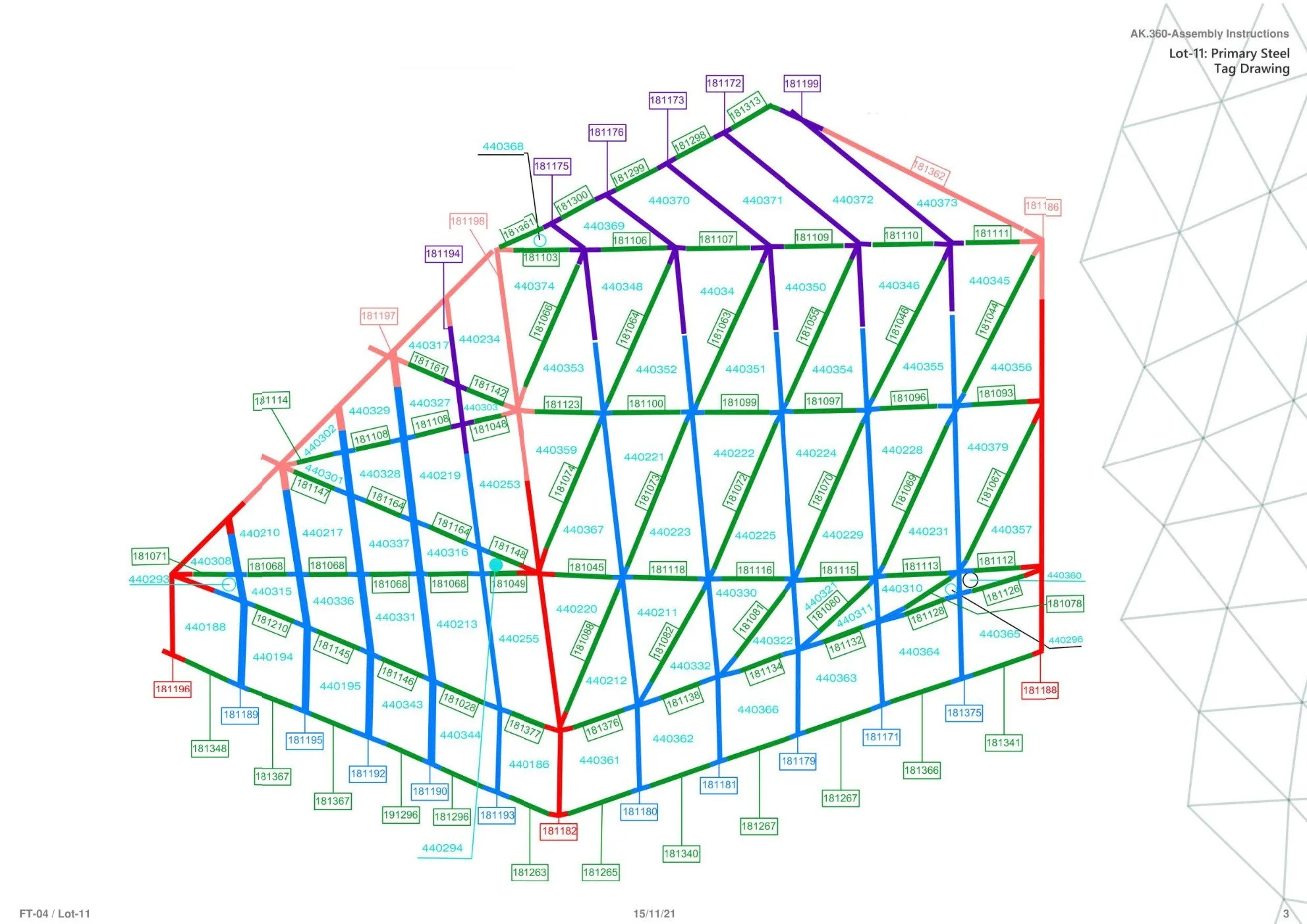

AK-360_FT-04_Primary Steel Assembly Instructions_SET Page 005.jpg

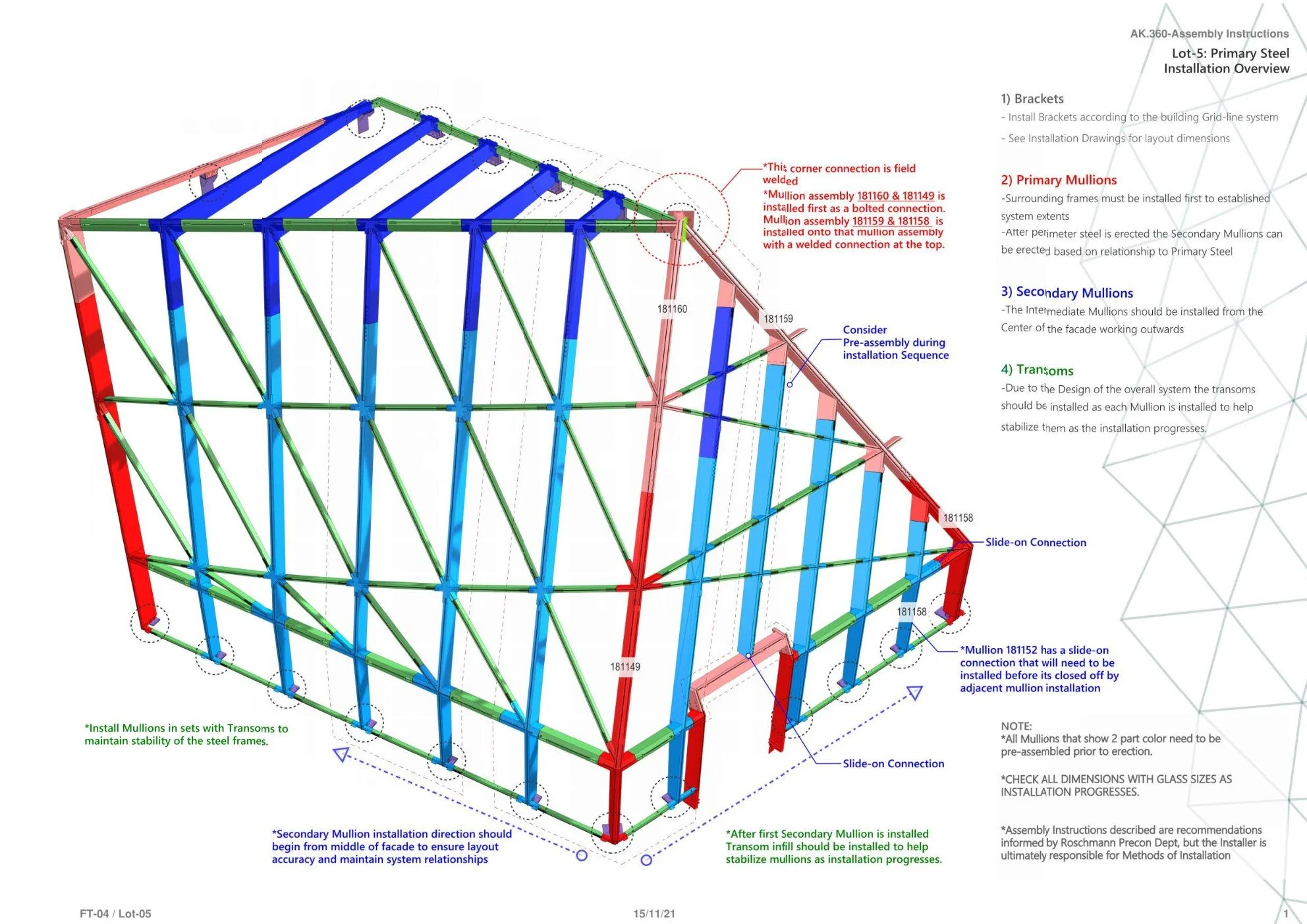

AK-360_FT-04_Primary Steel Assembly Instructions_SET Page 006.jpg

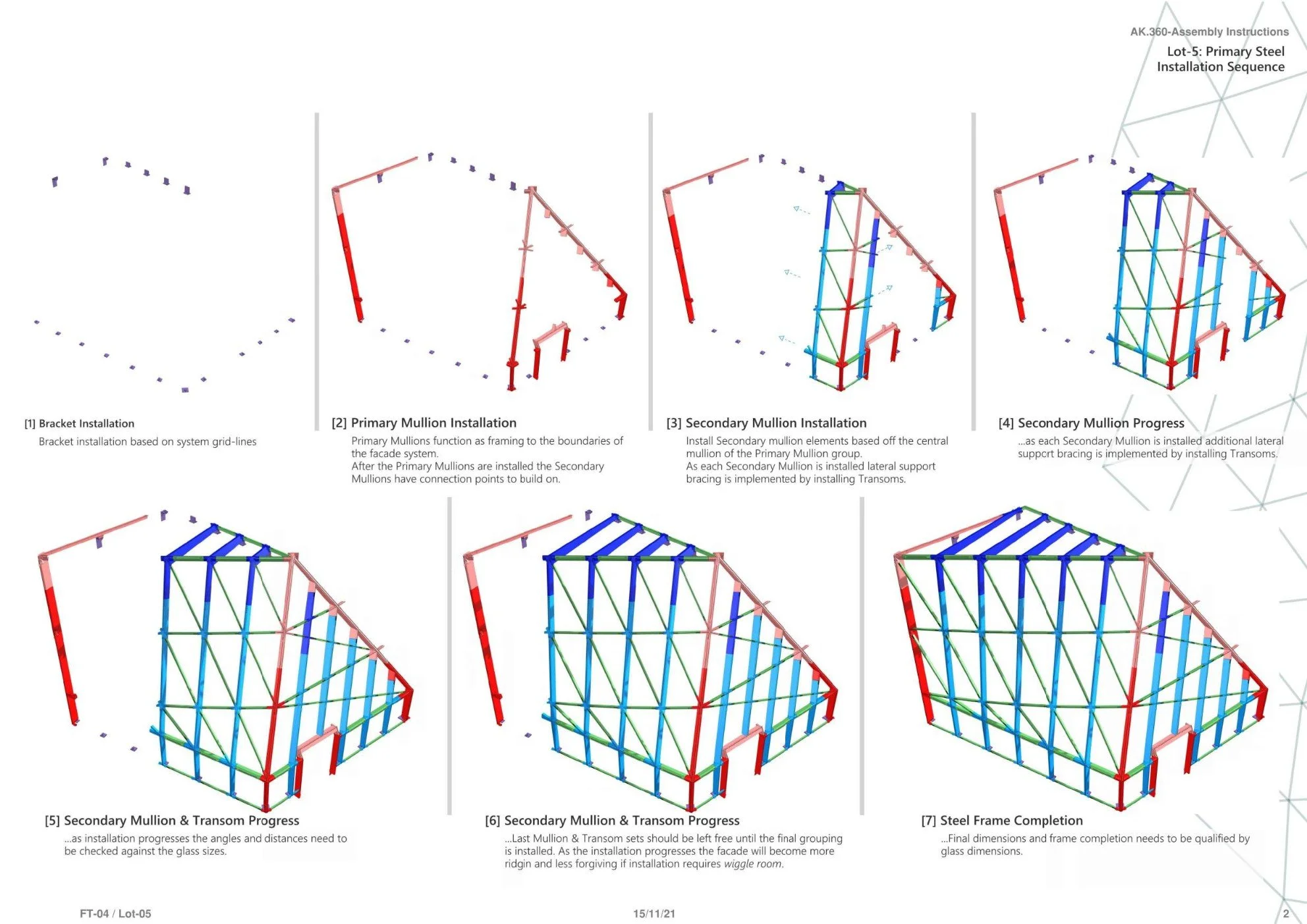

AK-360_FT-04_Primary Steel Assembly Instructions_SET Page 007.jpg

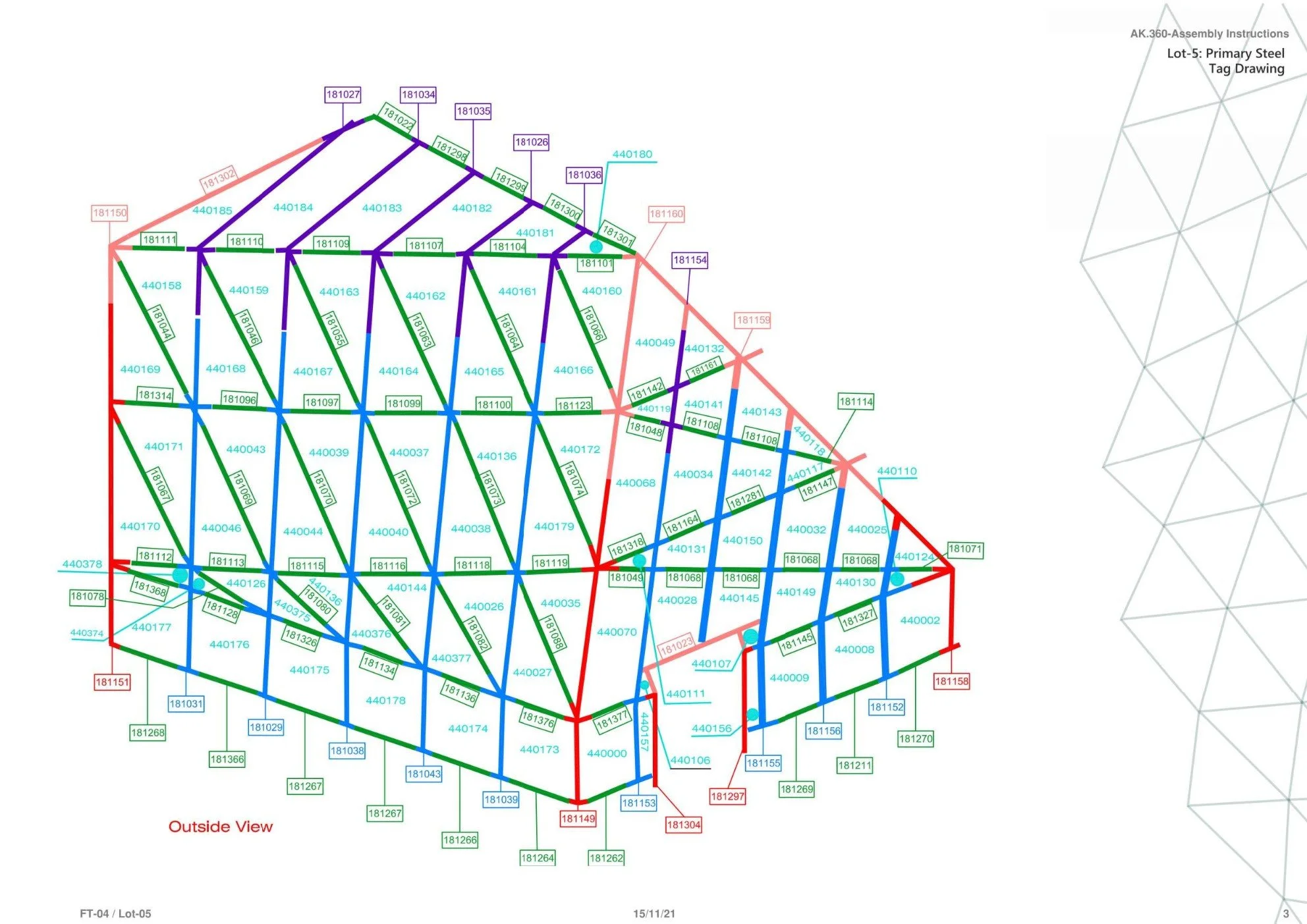

AK-360_FT-04_Primary Steel Assembly Instructions_SET Page 008.jpg

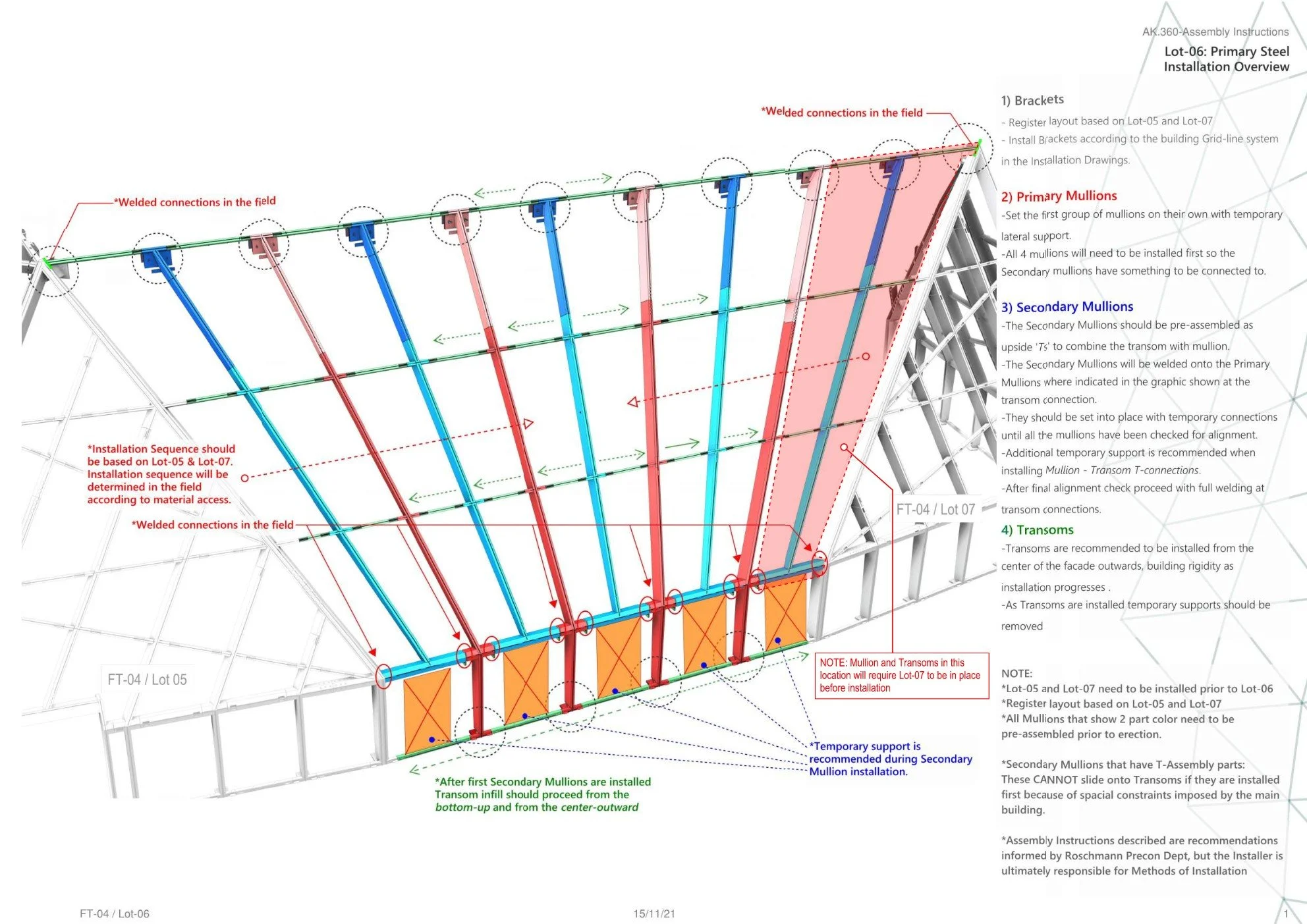

AK-360_FT-04_Primary Steel Assembly Instructions_SET Page 009.jpg
